Skip to main content
Home
Studying it · Building it · Renovating it — Free since 2008

Main navigation

  • Home
  • Architecture
  • Construction
  • Renovation
  • Materials
  • Interiors
  • Calculators

Breadcrumb

  1. Home
  2. Methods of Building Construction: The Practical Guide (With Examples)

Methods of Building Construction: The Practical Guide (With Examples)

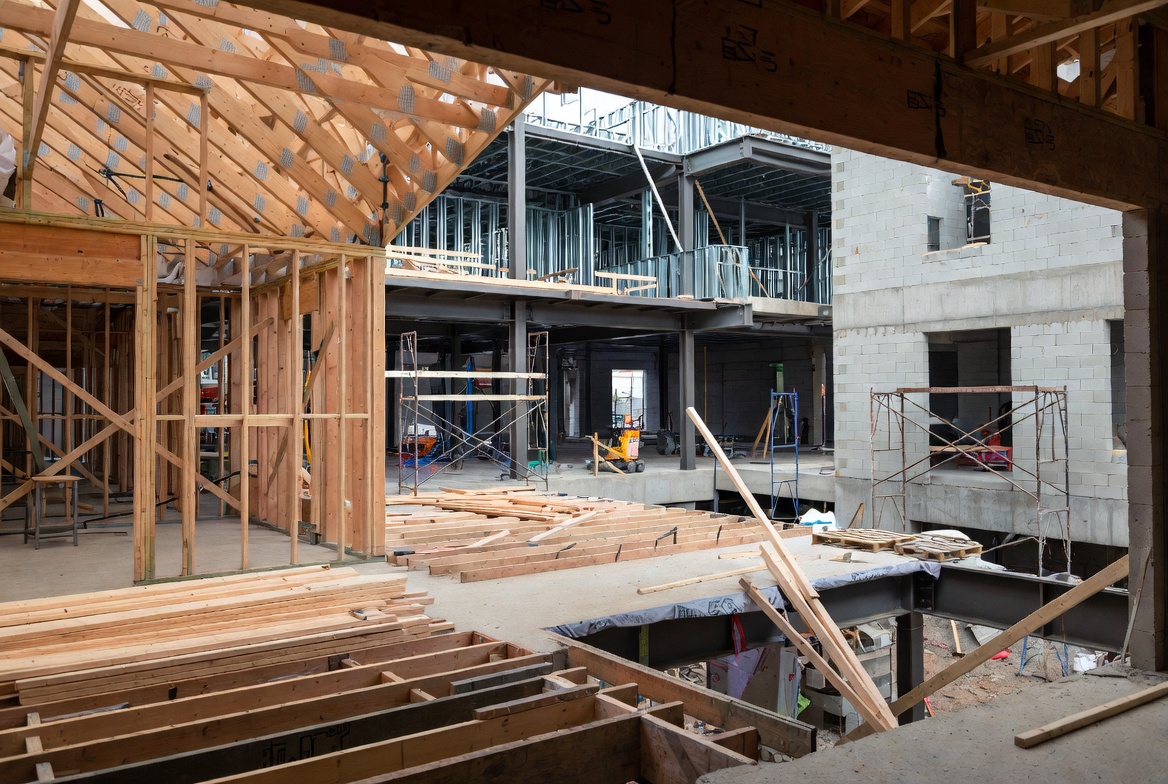

Wood, steel, and CMU building construction methods shown together on an active jobsite.

Building construction methodology is not a neat menu of systems you pick from once and then forget. The structure matters, obviously. So does the delivery method. But the thing that usually decides whether the job stays clean or turns into a daily argument is how the system, the site, the sequence, and the method statements fit together.

That is why this topic gets flattened so badly online. Too many guides talk about steel, concrete, masonry, timber, modular, and precast like they are isolated choices. Real projects do not behave like that. Ground conditions push back. Access changes what is practical. Tolerances punish sloppy work. Fire, water, and inspection requirements show up right where the details were weakest.

This guide lays out the main methods of building construction, the newer modern construction techniques, the difference between method, methodology, and method statement, and the standards people keep mixing up. It is written for people who need to make decisions: architects, builders, owners, students, and anyone tired of vague answers.

What This Guide Covers

Scaffolding and structure work in progress.
  • What “construction method” actually means on a job
  • Construction method vs construction methodology vs method statement
  • Traditional systems that still dominate most work
  • Modern methods like prefab, modular, and precast
  • Foundations, deep foundations, and excavation support
  • Sustainability, fire standards, and project measurement frameworks
  • Cost estimation, demolition planning, and method statement structure

What “Construction Method” Actually Means on a Job

When people say “methods of building construction,” they usually mean one of three things.

  • How the structure is formed: concrete, steel, masonry, timber, precast.
  • How the building is assembled: site-built, panelized, modular, hybrid.
  • How the work is controlled: sequencing, logistics, temporary works, inspections, QA, and method statements.

That third part gets ignored right up until it becomes the whole project.

A steel frame is not just “steel frame.” It is connection tolerances, fire strategy, access, lifting sequence, deck installation, bracing, inspections, and what the next trade needs to start. The same is true of concrete, masonry, timber, and modular work. The system matters. The sequence around the system matters just as much.

Before you even choose a system, the site starts narrowing the options. If you want the groundwork layer done properly, start with the site and groundwork hub. It is where a lot of “perfect” construction methods get punched in the mouth by real soil, real water, and real access limits.

Construction Method vs Construction Methodology vs Method Statement

Foundation drilling and site setup. Methods of building construction cover showing foundation drilling rig.

Construction method is the physical system or approach. Cast-in-place reinforced concrete. Steel frame with composite deck. Load-bearing masonry. Timber frame. Precast structure. Modular volumetric units.

Construction methodology is the project-level plan for how the work is delivered and controlled. Procurement route, sequence, crane and access planning, temporary works, inspection hold points, QA, testing, and handover logic. Methodology is what stops a project from becoming a daily emergency.

Method statement is the task-level plan. One activity, written clearly enough that a crew can follow it and a reviewer can sign it off. Slab pour. Pile installation. Precast erection. Waterproofing. Facade access. Demolition. If the task carries risk, it needs a method statement that is specific and usable.

Term What It Means Best Use What People Commonly Get Wrong
Construction Method The physical structural or assembly system Choosing how the building stands up and gets built Treating the system like it exists separately from site and sequence
Construction Methodology The full delivery and control plan Managing interfaces, logistics, QA, inspections, and risk Writing generic methodology language that never actually controls the job
Method Statement The task-specific work plan Explaining how one activity is executed safely and correctly Producing a document that sounds formal but tells the crew almost nothing useful

A method statement that reads like corporate policy is useless. A good one reads like it was written after somebody got burned once and did not want that repeated.

Traditional Building Methods That Still Dominate Most Work

Modern construction techniques get the headlines, but most buildings are still built with familiar systems. They keep winning because crews know them, inspectors know them, and supply chains are predictable.

Method Usually Wins On Usually Loses On The Detail That Gets Missed
Masonry Durability, familiarity, fire performance, low-rise work Weather sensitivity, slower production, workmanship dependence Water control depends on flashing, drainage, ties, and joints, not just the block or brick itself
Cast-in-place reinforced concrete Mass, stiffness, fire resistance, flexible geometry Formwork complexity, curing time, labor density Embeds, penetrations, and pour sequencing have to be coordinated early or the schedule starts bleeding
Steel frame Speed after fabrication, long spans, clean structural logic Fire protection cost, tolerance discipline, coordination demands Wrong embeds or bad connection geometry do not get forgiven in steel
Timber frame / engineered timber Light weight, speed, lower wet-trade load, cleaner installation Moisture sensitivity, sound control complexity, detailing risk Temporary weather protection is a real scope item, not an afterthought
Hybrid systems Practical mix of speed, familiarity, and performance Interface complexity Most failures happen at the seams between materials, not inside one material system by itself

Masonry Construction

Masonry is durable, fire-friendly, and straightforward in low-rise work. It is also slow when weather turns and quality depends heavily on the crew. A clean wall is not hard. A wall that stays dry and does not crack around every opening takes more discipline than people admit.

Load-bearing masonry still shows up, but on many larger projects masonry is veneer or infill with steel or concrete carrying the main structure behind it.

Cast-in-Place Reinforced Concrete

Summarizes methods across phases: foundations, structure, and coordination that keeps crews aligned and work buildable.

Cast-in-place concrete gives mass, stiffness, and solid inherent fire performance. It also brings formwork cycles, curing delays, and a lot of labor pressure in the same part of the schedule. Concrete looks simple until it starts eating time. Formwork slips. Rebar is late. Sleeves move. Embeds are off. Suddenly the next trade cannot start where it thought it could.

Concrete succeeds when the project treats pour sequencing like production work, not like a series of casual site events.

Steel Frame Construction

Steel goes up fast once fabrication is flowing. It is also unforgiving. If a connection is wrong, it is wrong in steel. If embeds drift, the frame does not politely move to meet them. Fire protection strategy matters early because it changes cost, inspection path, and sequence.

When people want a quick baseline in how loads and stability actually work, this structural analysis guide is the right companion page. It helps once spans, lateral systems, and load paths stop being background issues and start driving the whole job.

Timber Frame and Engineered Timber

Timber systems can be fast, light, and clean. They also demand moisture control and careful detailing. A wet timber job can turn into swelling, staining, callbacks, and sound complaints faster than people expect. Sound control matters too. Timber assemblies often need mass, decoupling, and careful penetrations to perform well.

Hybrid Construction

Most real buildings are hybrids: concrete foundations, steel frame, masonry veneer, precast stairs, light-gauge infill, prefab MEP runs. Hybrid is normal. Interfaces are where it breaks. If the transition details are sloppy, you get leaks, misalignment fights, and patchwork repair that lasts half the job.

Modern Construction Techniques: Faster Usually Comes With Strings Attached

Modern methods of construction usually aim to move work offsite, reduce wet-trade time onsite, and compress schedules. That can be excellent. It can also backfire if the team tries to run it like a conventional project and refuses to accept what needs to be decided earlier.

Prefabrication

Prefabrication is component-level offsite work: wall panels, facade panels, bathroom pods, MEP racks, plant skids, rebar cages. The big win is consistency and reduced site congestion. The big trade-off is earlier commitment. If the client loves late changes, prefab becomes expensive in a hurry.

Modular Construction

Modular construction means full three-dimensional units built offsite, shipped, and connected onsite. It works best when layouts repeat and the building form is disciplined. Hotels, student housing, clinics, classrooms, and similar repeat-heavy programs usually fit better than highly custom work.

Where modular struggles is custom design, tight urban logistics, and clients who change their minds weekly. Module joints and connections are also where water and sound problems show up if details are lazy.

Offsite MEP Racks

This is one of the most underrated modern construction methods because it is not flashy. It is just effective. Corridor racks, repeated bathroom groups, coordinated service zones. It reduces stacked trades and shortens the MEP chaos phase that kills schedules.

BIM and Coordination

BIM helps most when it is used to coordinate openings, embeds, penetrations, and service routes before fabrication. It does not fix missing decisions, and it does not replace somebody actually understanding the plan set.

If you want to tighten coordination fast, this blueprint reading guide is the right baseline. Most coordination failures are not advanced. They are ordinary plan-literacy failures that get more expensive each week.

Precast Concrete Construction: Fast, Clean, and Very Intolerant of Sloppy Layout

Precast concrete construction means manufacturing elements in a plant, shipping them, and erecting them onsite. Common precast elements include architectural wall panels, insulated sandwich panels, columns, beams, spandrels, structural tees, hollowcore slabs, and precast stairs.

What precast is great at: speed of enclosure, repeatable bays, consistent finishes, cleaner production once approvals are locked.

What precast punishes: bad coordination and bad tolerances. Precast does not like “we will fix it later.” If embed plates are off, you get shims, weld repairs, drilling, patching, and schedule damage.

Typical Precast Erection Flow

  1. Verify as-built foundation levels and embed locations.
  2. Approve shop drawings and connection details early.
  3. Plan delivery order so you are not moving units multiple times.
  4. Set elements with controlled exclusion zones and realistic crane sequencing.
  5. Install temporary bracing immediately, then complete permanent connections.
  6. Hold QA points for critical connections, grouting, and tolerance checks.
  7. Seal joints and weatherproof interfaces before anyone starts calling the building enclosed.

Precast looks simple from the street. On the ground it is a tolerance game. If you cannot hit layout, precast will humble you.

Foundations, Deep Foundations, and Excavation Support

Most construction-method decisions get dragged around by foundations. The building above is easy compared to bad ground below. That is why site investigation is never busywork.

If you need a proper foundation and soil baseline, this foundations and soil guide covers the investigation mindset that prevents the worst surprises.

Shallow Foundations

Strip footings, pad footings, and slabs-on-grade are simple when soils are stable, water is controlled, and frost is handled properly. They get complicated when you have fill of unknown quality, high groundwater, or adjacent structures that cannot tolerate movement.

Deep Foundations

Deep foundations show up when shallow options cannot safely carry the load or settlement risk is too high. Common types include driven piles, drilled shafts, CFA piles, micropiles, and helical piles.

Precast Concrete Pilings

Precast pilings are often prestressed and driven. They can deliver high capacity and consistent quality, and they install quickly once the rig is mobilized. They work best when pile quantity justifies mobilization, vibration and noise are manageable, and the ground does not fight the driving process with constant obstructions.

They become harder on tight urban sites, sites with debris fill, or sites where delivery access and pile handling are constrained. The cost drivers are usually not mysterious: mobilization, access, pile length, testing, and ground risk. Anyone quoting pile cost without geotechnical context is guessing.

Secant Pile Shoring and Excavation Support

Urban excavation is where projects get expensive fast. Tight property lines, groundwater, traffic staging, sensitive neighbors, and zero laydown space. That is why shoring methods matter.

Secant pile walls are built from overlapping drilled piles. Done properly, they create a near-continuous wall with good stiffness and reduced water ingress compared with simpler systems. They get chosen when you need deep excavation support close to neighboring structures and want less vibration than driven sheet piling.

They still demand precision. Verticality, reinforcement placement, concrete quality, and monitoring. If those slip, the wall becomes an argument you cannot win.

Shoring Option Usually Best For Main Advantage Main Weak Point
Secant piles Deep urban excavation near sensitive structures Stiff wall with reduced vibration and better water control High precision and higher cost
Soldier piles and lagging Moderate-depth excavation with manageable water conditions Common and flexible Movement and leakage can be harder to control
Sheet piling Fast support where vibration is acceptable Speed Noise, vibration, and imperfect watertightness
Diaphragm walls Major urban work with high-performance requirements Strong structural and groundwater performance High cost and specialist execution

Sustainable Construction Methods: The Moves That Actually Change Performance

Sustainable building techniques get marketed like gadgets. Most of the real wins are not gadgets. They are repeated, boring decisions done consistently.

Envelope First

Most buildings waste energy because the envelope leaks and bridges. Fix that and half the “green” talk becomes real.

  • Air control. If air leaks, moisture moves and energy bleeds.
  • Continuous insulation. Thermal bridges quietly create cold spots, condensation, and heat loss.
  • Window sanity. Wrong glazing ratios and poor installation create lifetime comfort and water problems.
  • Rain control that assumes failure. Flashings, drainage planes, and drying potential matter more than product hype.

Low-Carbon Structure Choices

Embodied carbon is mostly structure. Concrete volume, steel tonnage, timber strategy, and reuse decisions. The greenest square foot is often the one you do not build, but when you do build, structural efficiency matters.

Reuse Beats New Build More Often Than People Like to Admit

Adaptive reuse is not always easy, but it can be the biggest sustainability move in the room. Keeping an existing frame and upgrading envelope and services often beats a total replacement on carbon and waste.

For sustainability principles that tie back to real design and construction decisions, this green architecture guide is a useful companion read.

BOMA Measurement, BREEAM, and Why Paperwork Quietly Changes the Building

Captures method in action: temporary works, rebar layout, checks, and concrete prep before the pour.

Some standards do not look like construction methods, but they still change design and delivery.

BOMA Measurement

BOMA standards affect how building area is measured, especially on commercial projects. That changes rentable area, usable area, common-area allocations, and sometimes the way cores, corridors, and amenity spaces get laid out. Ignore it and you can end up redesigning late for leasing logic instead of building logic.

BREEAM

BREEAM is a sustainability assessment framework. In practice, it pushes better site management, documentation, waste tracking, sourcing discipline, and commissioning. It also adds admin load. Projects that treat BREEAM as a late add-on usually suffer. Projects that build it into procurement and site controls early do better.

ASTM E84 and ASTM E119: Stop Mixing These Up

This confusion causes real problems in specifications and submittals.

Standard What It Covers Use This For Do Not Assume
ASTM E84 Surface burning characteristics Interior finish flame-spread and smoke-developed classification That it proves a full wall or floor assembly has a time rating
ASTM E119 Fire resistance of assemblies and elements under standardized exposure Rated walls, floors, protected structural elements, and assembly performance That swapping layers, adhesives, joints, or penetrations keeps the tested assembly valid automatically

Fire compliance is not just material selection. It is the assembly, the penetrations, the joints, and the details that get inspected. If you want code and life-safety content explained without drowning in jargon, keep this residential code breakdown nearby and use NFPA 101 life safety basics for egress and occupancy questions.

Construction Project Cost Estimation: What “Detailed Estimate” Really Means

Estimation is where optimism usually starts losing the fight. The first budget is almost always too clean. Then the site shows up. Then trades price reality. Then scope grows quietly through “small changes.”

Concept Estimates

Early estimates are usually based on area rates plus major allowances. They are useful for go/no-go decisions. They are not tender-ready and they are not “the price.”

Elemental Estimates

This breaks the budget into chunks: substructure, structure, envelope, interiors, mechanical, electrical, siteworks, preliminaries. This is where you can start seeing what is driving cost. Heavy excavation. Heavy facade. Long spans. Mechanical intensity. This is where value engineering can be rational instead of desperate.

Detailed Takeoff Estimates

This is quantity-based. Count, measure, rate, then add contingency and escalation logic that is actually explained. A good detailed estimate also states what is included and what is excluded so people stop pretending later.

If you want grounded cost context for residential work, this cost per square foot guide is a useful reference point.

Estimate Type Best Used For What It Usually Includes What It Usually Misses
Concept estimate Early feasibility Broad area rates and large allowances Precise scope differences and site-specific pain
Elemental estimate Design-stage cost control Major system-based cost breakdown Some task-level procurement detail
Detailed takeoff estimate Tendering and buying decisions Measured quantities, rates, inclusions, exclusions Nothing important, if the drawings are actually coordinated

Demolition Works: Method Statement Basics That Keep People Safe

Demolition is not “knock it down.” It is controlled removal. The method statement is not paperwork. It is what stops injuries and keeps the building from collapsing in the wrong direction.

Any demolition method statement should address:

  • surveys and hazardous materials: asbestos, lead, mold
  • utilities isolation, verified and not assumed
  • structural stability and temporary support where needed
  • public protection, exclusion zones, and overhead protection if required
  • dust suppression and runoff control
  • waste streams and disposal documentation
  • stop-work triggers when conditions change

Demolition goes wrong when people rush soft strip, skip verification, or treat utilities as “probably dead.” That is where disasters start.

A Method Statement Template That Is Actually Usable

If you want a method statement that holds up under review, keep it tight. One activity. Clear steps. Clear controls. Clear hold points.

  1. Scope – exact activity, boundaries, interfaces
  2. References – drawings, specs, permits, standards
  3. Roles – supervisor, safety lead, QA, sign-off authority
  4. Tools and Equipment – including lifting gear or plant certification where needed
  5. Materials – what arrives, how it is stored, what gets checked
  6. Access and Logistics – deliveries, laydown, traffic control, exclusion zones
  7. Sequence of Work – short, numbered, direct
  8. Temporary Works – bracing, shoring, supports, inspections
  9. Hazards and Controls – what can hurt people and how it is controlled
  10. Inspection Hold Points – what must be checked before the next step
  11. Testing and Records – photos, test reports, checklists, as-builts
  12. Environmental Controls – dust, noise, runoff, waste handling

A good method statement does not try to impress anyone. It tries to prevent predictable failures.

Method Interfaces: Where Good Systems Still Fail

Most construction methods do not fail because the method itself is bad. They fail at the seams between trades, between factory and site, and between design intent and field reality.

If you want fewer claims, fewer rework days, and fewer “how did this pass inspection?” moments, build your thinking around interfaces, not buzzwords. Start with the ground and sequence from there. Your best friend is a real site prep plan and boring logs, not a shiny rendering. For groundwork sequencing, keep this site and foundation prep hub open while you plan.

Interface #1: Ground to Foundation

  • Why it fails: weak soils, uncontrolled fill, missed groundwater, lazy compaction testing, grading treated like something that can be cleaned up later.
  • What it looks like: slab cracking, doors binding, tile failure, facade movement, piles and caps fighting each other.
  • How to stop it: use real hold points for proof-roll, density, moisture, bearing-level acceptance, and drainage verification.

Interface #2: Structure to Envelope

  • Why it fails: structure tolerances, rushed cladding, and “we’ll foam it” thinking.
  • What it looks like: chronic leaks at slab edges, window corners, parapets, and precast joints.
  • How to stop it: use mockups, agreed tolerances, and one clear owner of the air-water line instead of five trades each covering “their bit.”

Interface #3: Offsite to Onsite

  • Why it fails: modules or panels arrive right while the foundation or embed layout is wrong by just enough to ruin the day.
  • What it looks like: field drilling, torching, shimming, and temporary fixes that never feel temporary again.
  • How to stop it: treat survey control and as-built verification like production gates, not paperwork.

Interface #4: Fire to Finish Materials

  • Why it fails: the spec says one thing, procurement swaps a product, installer changes an adhesive, and nobody checks the assembly again.
  • What it looks like: failed inspections, ripped-out finishes, and very expensive late panic.
  • How to stop it: map assemblies clearly to test standards and make acceptance criteria part of the method statement and submittal review.

The Hold-Point Table You Can Actually Use

Work Package Hold Point What Gets Checked Common Failure
Earthworks Subgrade acceptance Proof-roll, compaction, moisture, drainage falls “Looks fine” grading followed by settlement later
Foundations Rebar and embed inspection Cover, laps, chairs, anchors, sleeves Anchors drift and steel or precast no longer lands cleanly
Precast or modular set Survey and bearing verification Levels, plumb, pads, tolerance band Shimming and field fixes fight joints and finishes
Envelope Mockup approval Water testing, air-seal continuity, flashings, transitions Leaks discovered after interior work starts
Firestopping Assembly verification Rated details match tested assembly and installation method Unrated filler or unverified substitutions get buried
Closeout As-builts and O&M handover Manuals, commissioning records, test reports Future maintenance becomes guesswork

What To Do Next

If the real issue is not the structural method but the site constraints underneath it, go back to the site and groundwork hub. If the next problem is structural logic and load paths, use this structural analysis guide. If the project keeps failing at coordination rather than design intent, the blueprint reading guide is the better next step.

FAQ

What are the main methods of building construction today?

Traditional site-built systems such as masonry, timber, concrete, and steel still dominate, usually alongside offsite methods like panelization, precast, modular units, and prefab MEP systems. Most real projects are hybrids.

What is the difference between a construction method and a method statement?

The construction method is the system or physical approach. The method statement is the task-specific work plan for carrying out one piece of that work safely and correctly.

When does precast concrete construction make sense?

When the project benefits from repeatable bays, fast enclosure, controlled finishes, and a realistic crane and logistics plan. It gets risky when the team ignores tolerances, embeds, and connection detailing.

Are precast concrete pilings worth it?

They can be excellent in the right soils and project conditions, especially where quantity justifies mobilization and vibration is manageable. They become harder on constrained urban sites or sites with unknown obstructions.

What is building construction methodology in plain English?

It is the overall plan for how the project will be delivered and controlled: system choice, sequence, temporary works, logistics, inspections, QA, and handover logic.

What does ASTM E84 tell you?

It compares surface burning characteristics such as flame spread and smoke development. It does not prove a whole wall or floor assembly has a time-based fire rating.

What does ASTM E119 tell you?

It deals with fire resistance of assemblies and elements under standardized fire exposure. That is the territory of rated walls, floors, protected steel, and tested assemblies.

What is BOMA measurement and why does it matter?

It is a standardized way of measuring building area, especially in commercial work. It affects rentable area, usable area, and sometimes design decisions tied to leasing and valuation.

What is BREEAM and where does it affect construction?

It is a sustainability assessment framework. It affects procurement, documentation, site controls, waste tracking, commissioning, and how early the project takes sustainability requirements seriously.

Official sources
  • BOMA International — BOMA Standards: https://boma.org/boma-standards/
  • ANSI Webstore — ANSI/BOMA Z65.1-2024: https://webstore.ansi.org/standards/ansi/ansibomaz652024
  • BREEAM — Main site: https://breeam.com/
  • BREEAM — New Construction standard overview: https://breeam.com/standards/new-construction
  • ASTM International — ASTM E84: https://www.astm.org/e0084-21a.html
  • ASTM International — ASTM E119: https://www.astm.org/e0119-20.html
  • UK Government — MMC Definition Framework: https://www.gov.uk/government/publications/modern-methods-of-construction-working-group-developing-a-definition-framework
  • HSE — Demolition guidance: https://www.hse.gov.uk/construction/safetytopics/demolition.htm
  • Precast/Prestressed Concrete Institute — Guides and manuals: https://www.pci.org/GuidesAndManuals
  • CPCI — Precast concrete resources: https://www.cpci.ca/en/resources
  • FHWA / ROSA P — Driven pile foundations: https://rosap.ntl.bts.gov/view/dot/39220
  • FHWA — Driven pile construction issues: https://www.fhwa.dot.gov/publications/research/infrastructure/geotechnical/05159/index.cfm
  • Keller — Secant/tangent piles overview: https://www.keller-na.com/expertise/techniques/secant-tangent-piles
  • Modular Building Institute — What is modular construction: https://www.modular.org/what-is-modular-construction/

Subscribe

Popular

Complete guide to aluminum window and door frames.
Aluminum Window Frames: Pros, Cons, and Where They Make Sense
Mid-century modern house exterior in Palm Springs with clean lines, flat roof, and expansive glass windows.​
1950s Houses: What They Are, What Works, What Doesn’t
Architecture graduate studying drawings, models, and exam materials in a studio workspace.
How to Become a Licensed Architect: School, Hours, and Exams
Installed crawl space vapor barrier with taped seams, wall turn-up, and wrapped piers.
Cost to Install a Crawl Space Vapor Barrier: Where the Money Goes

ArchitectureCourses.org

Practical architecture, construction, and renovation guides for real projects.

Explore

  • Architecture
  • Construction
  • Renovation
  • Crawl Space
  • Materials
  • Interiors
  • Reviews
  • Calculators

Company

  • Home
  • About
  • Privacy Policy
  • Subscribe

© 2026 ArchitectureCourses.org. All rights reserved.

As an Amazon Associate, we earn from qualifying purchases at no extra cost to you.
